2026 Release Notes

29 September Release

This Train 18 release introduces new controls for preserving information as work progresses through Fluid, alongside a number of improvements to boards, project pipelines, schedules and timesheets.

Closed cards, projects, schedule tasks and impacts can now retain the property configuration they had when they were closed, workflow approvals can capture the card as it appeared at the time of the decision, and custom properties can be made read-only after an item reaches a particular status.

Boards also gain a redesigned card status control, improved archiving behaviour and configurable card descriptions. Project Pipeline cards can now carry Editors and Viewers through to the projects they create, while a new schedule setting lets organisations choose whether timesheet bookings should update task % Complete.

The release also includes a number of smaller enhancements and fixes.

Keep the record as it was: freezing, snapshots and locking

Closed items now keep the property configuration they closed under

Custom property configuration has always been shared by every item on a board or in a scope. So when a board owner renamed a property, removed an option from a list, or regrouped a board's properties, every closed or archived item changed with it. An item you closed a year ago could quietly stop matching what was actually approved at the time: a value could end up under a different label, or show an option that no longer exists in the list it came from. For audits and governance reviews, the record you looked back at wasn't reliably the record you closed.

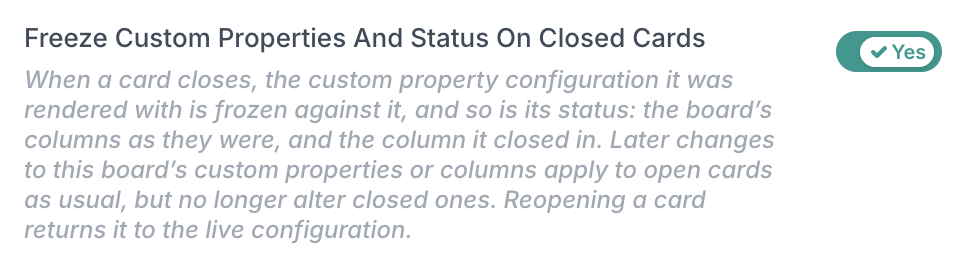

To address this issue, we've added a new board setting: Freeze Custom Properties And Status On Closed Cards.

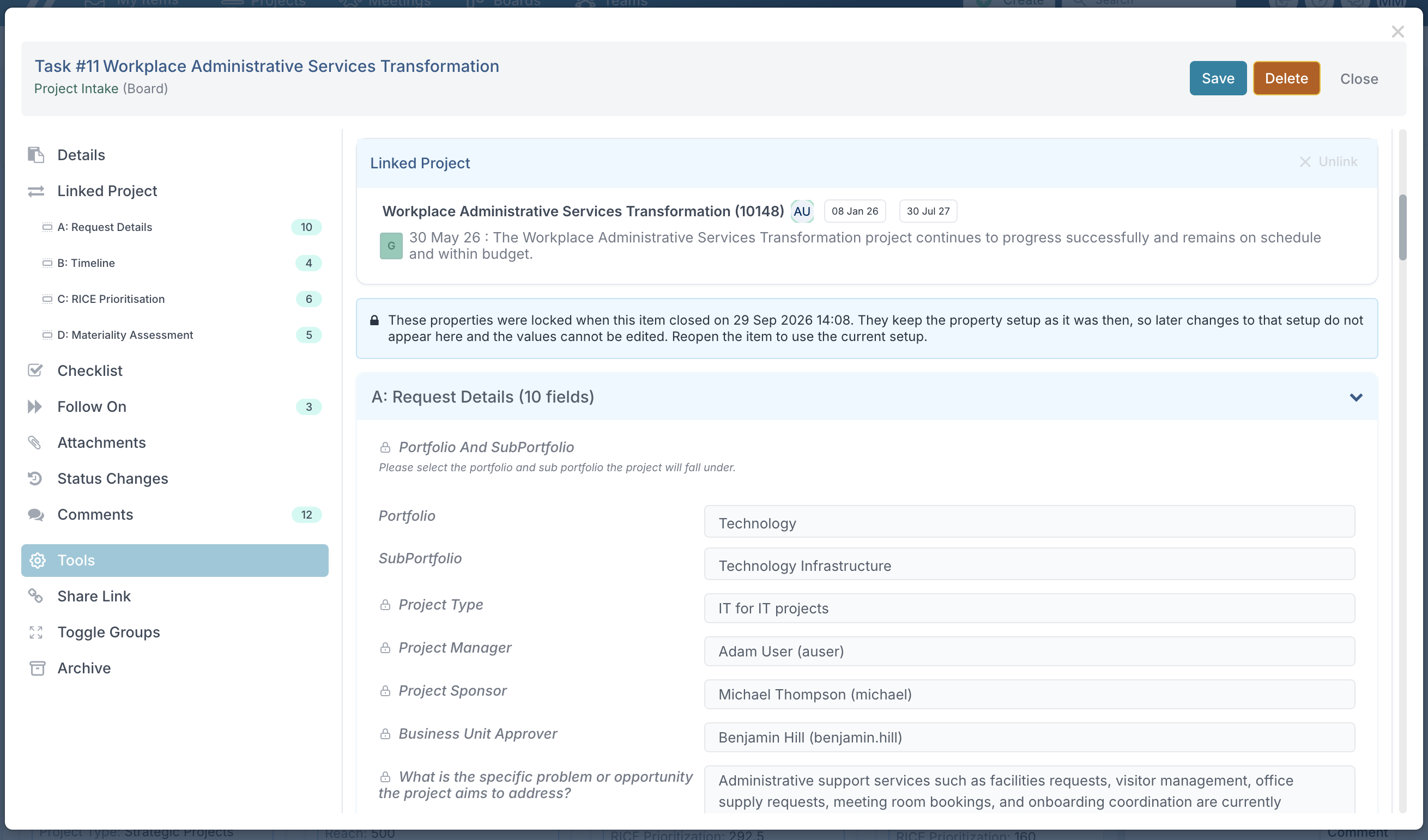

If turned on, when a card is closed or archived, Fluid saves a copy of the custom property setup it closed under, and the closed item displays from that copy from then on:

  • Closed and archived items are frozen exactly as they closed. Every property is shown read-only, calculated expressions no longer re-evaluate, and any attempt to change a value is ignored. Later configuration changes — renames, removed options, regrouping — affect open items only.

  • Reopening restores normal behaviour. A reopened item returns to the live configuration and is fully editable again; if it's closed once more, a fresh copy is taken.

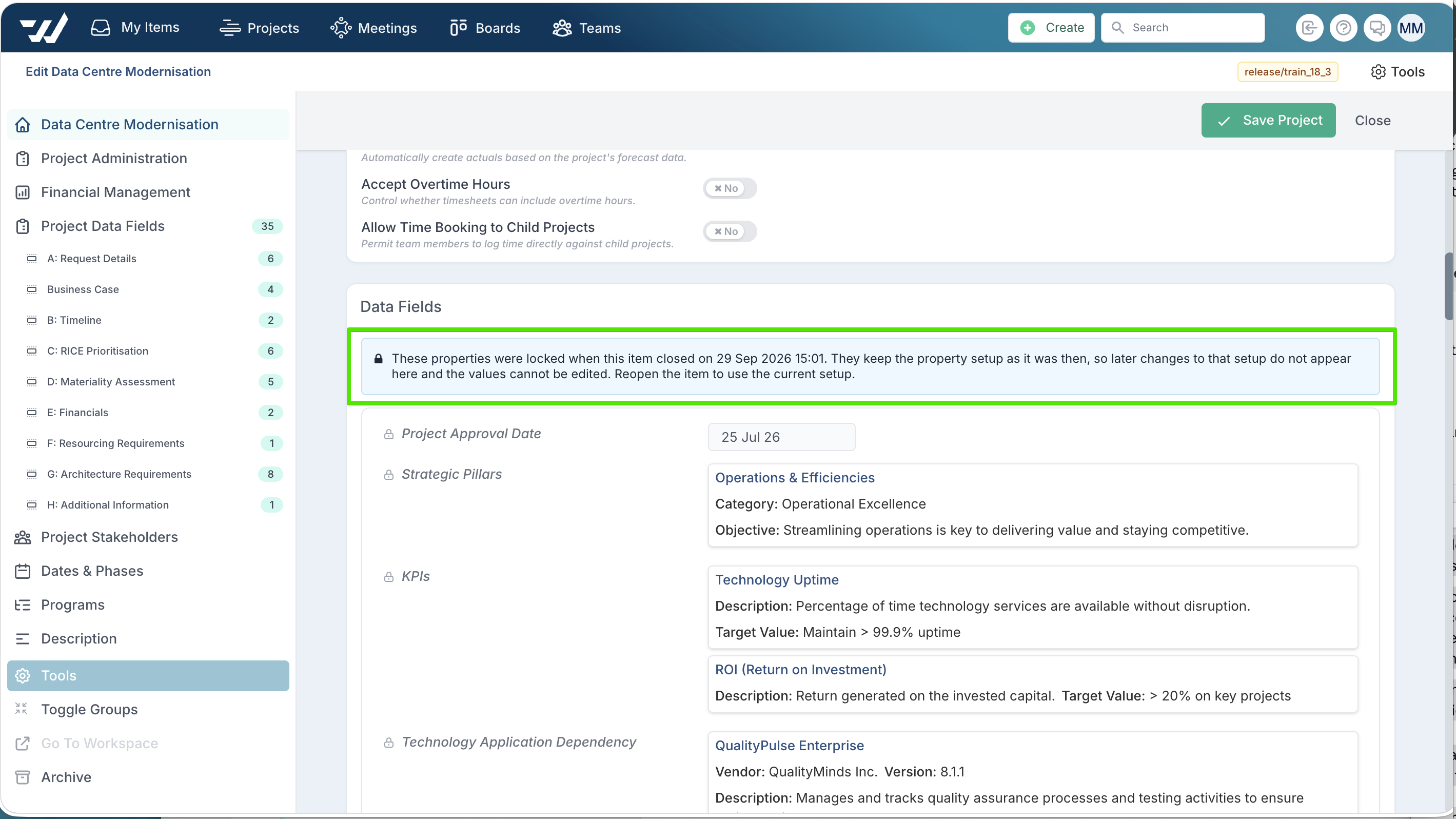

Freeze properties on closed projects, schedule tasks and impacts

The same snapshot functionality is available on projects. A new global setting, Freeze Closed Entity Properties, applies the freeze to projects, schedule tasks and impacts.

For projects, the freeze is tied to the project status. A project counts as closed the moment its status is changed to one of the statuses your organisation has configured as inactive, such as Closed, Completed or Cancelled, and also when the project is archived. At that moment Fluid records the closure date and saves a copy of the custom property configuration the project closed under.

Schedule tasks and impacts are frozen in the same way when they are closed. Properties on a closed item are shown read-only, calculated expressions stop re-evaluating, and changes are ignored. Later renames, removed options or regrouped properties never alter what a closed project, task or impact shows.

Moving a project back to an active status, or restoring it from the archive, returns it to the live configuration, fully editable. Closing it again takes a fresh copy. The same applies to reopened tasks and impacts.

Unlike the board setting, which is enabled board by board, this is one system-wide setting covering all three item types, switched on by your project administrators. It is off by default, and it applies to items closed or archived after it is turned on. Items already closed continue to follow the live configuration.

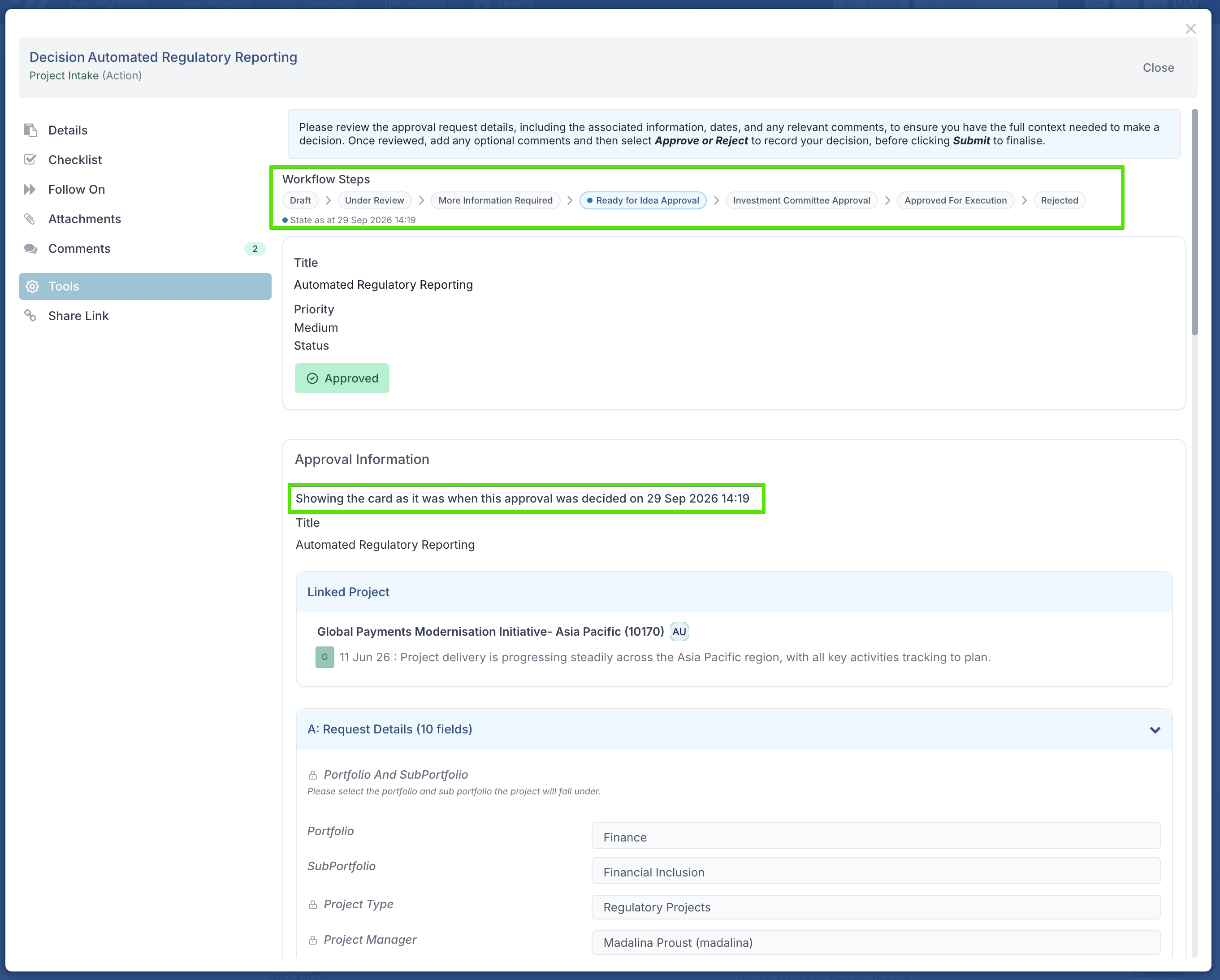

Workflow approvals now keep the card they were decided on

An approval decision is only as good as the record of what was approved. Until now, opening a settled approval showed the card as it is today and not how it was when the decision was approved.

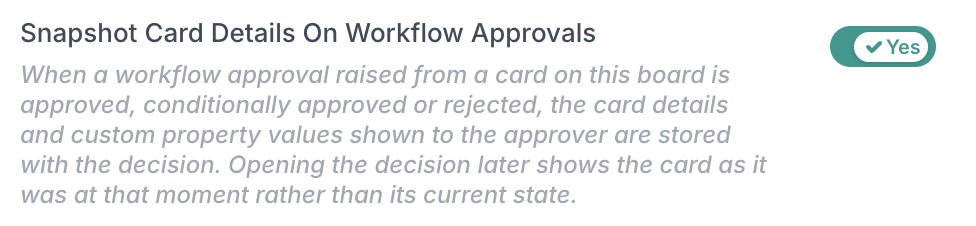

To address this, we've added a new board setting: Snapshot Card Details On Workflow Approvals.

If turned on, whenever an approval is approved or rejected, Fluid stores the card exactly as the approver saw it, attached to that decision:

  • The snapshot is taken at the moment of decision, before the outcome moves the card to its next column — so it captures the card in the state it was judged, fields and property values alike.

  • Opening an approval decision shows the status of the card at the time the decision was approved or rejected and the card's properties are displayed as read-only, marked with the time they were captured.

  • The live card is unaffected. The snapshot is a record attached to the decision; the card itself continues through its workflow as normal, and each subsequent approval on it captures its own snapshot.

Like the freeze setting, this is off by default and enabled per board. Switch it on for the workflow boards where decisions need a durable record. Approvals decided before the setting is switched on have no snapshot; opening those shows the live card, as today.

Lock custom properties after an item reaches a certain status

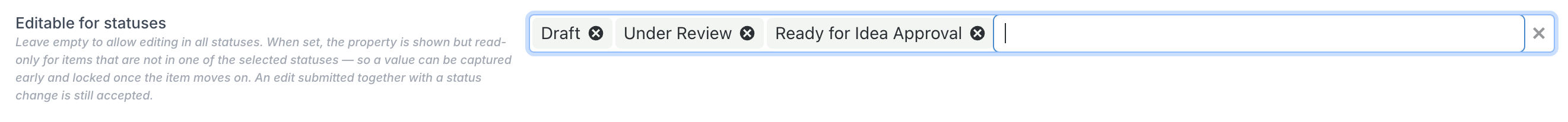

Custom properties now include a new Editable for statuses setting, alongside the existing Applicable and Required settings. This lets you capture information early in a workflow and then prevent it from being changed once the item has moved beyond the point where that value was agreed.

For board card properties, the setting uses board statuses. For project properties, it uses project statuses.

Specify the statuses in which the property can be edited. In all other statuses, the property remains visible but becomes read-only. If no statuses are selected, the property stays editable everywhere, preserving the existing behaviour for all current properties.

For example, a Business Case Amount could be editable while a card is in Draft or Under Review, then become read-only once the card reaches Approval, ensuring the approved value remains unchanged.

Status changes are also handled without blocking normal workflow progression. A user can still update a property while moving an item out of a status where it is editable, and moving an item back into an editable status makes the property editable again. A save is blocked only when the property is read-only in both the current and destination statuses.

Card status, archiving and descriptions

Card status is now a step strip at the top of the dialog

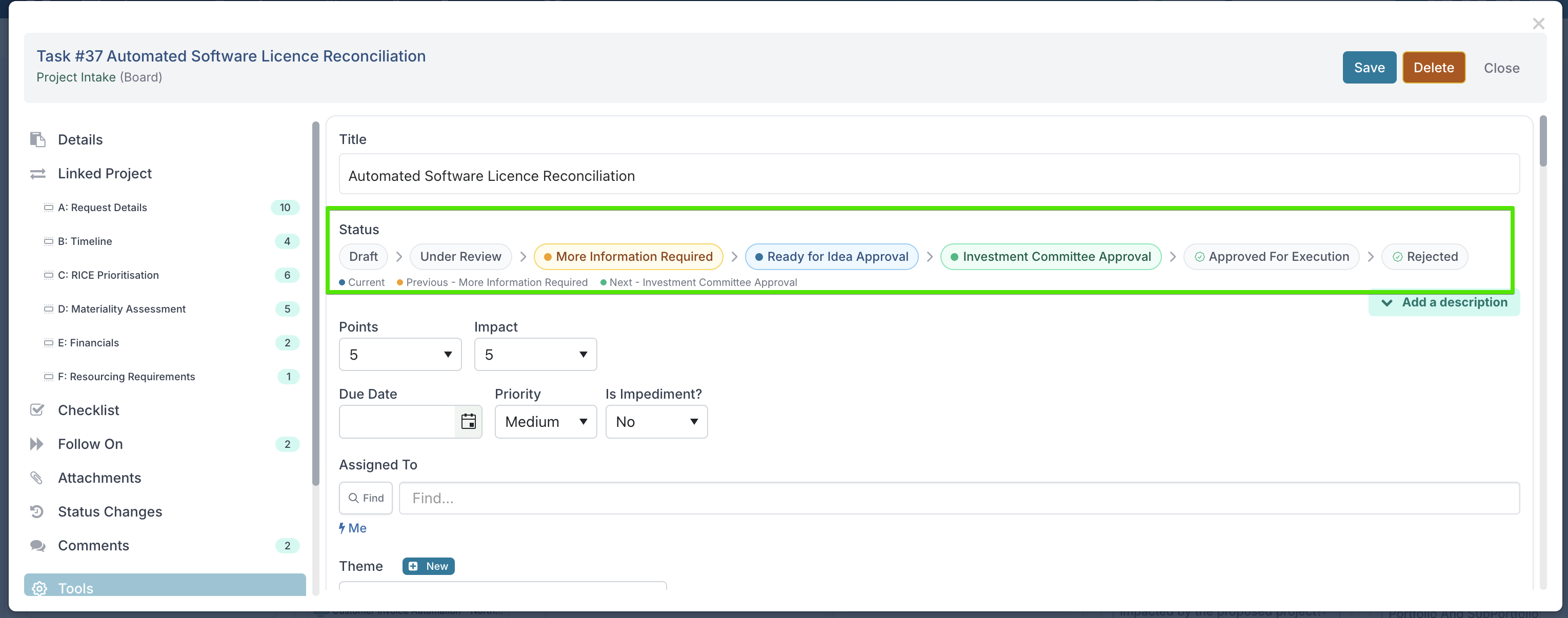

The card's status control has moved to the top of the edit dialog and become a strip of steps, replacing the status dropdown. Every column of the board is laid out in order as a pill, so the card's whole journey — where it's been, where it is, and where it goes next — is visible at a glance.

To change the card status, click any pill to move the card to that column, then save.

Reading the strip

  • Blue — the column the card is in now, repeated as Current in the legend beneath.

  • Green — the next column to the right, named in the legend (Next – Investment Committee Approval). If moving there will close the card, the legend says so: (closes the card).

  • Amber — the column the card came from, named in the legend (Previous – More Information Required).

  • Grey — every other column. A grey column marked with a green check badge is one that closes the card when it reaches it.

Closed cards on boards that freeze them

On boards using the new Freeze Custom Properties And Status On Closed Cards setting, a closed card's strip becomes a historical record: it shows the board's columns as they stood when the card closed, and the blue marker is labelled with that moment (State as at 29 Sep 2026 14:08) rather than Current. Because those columns may since have been renamed or removed, the frozen strip can't be clicked.

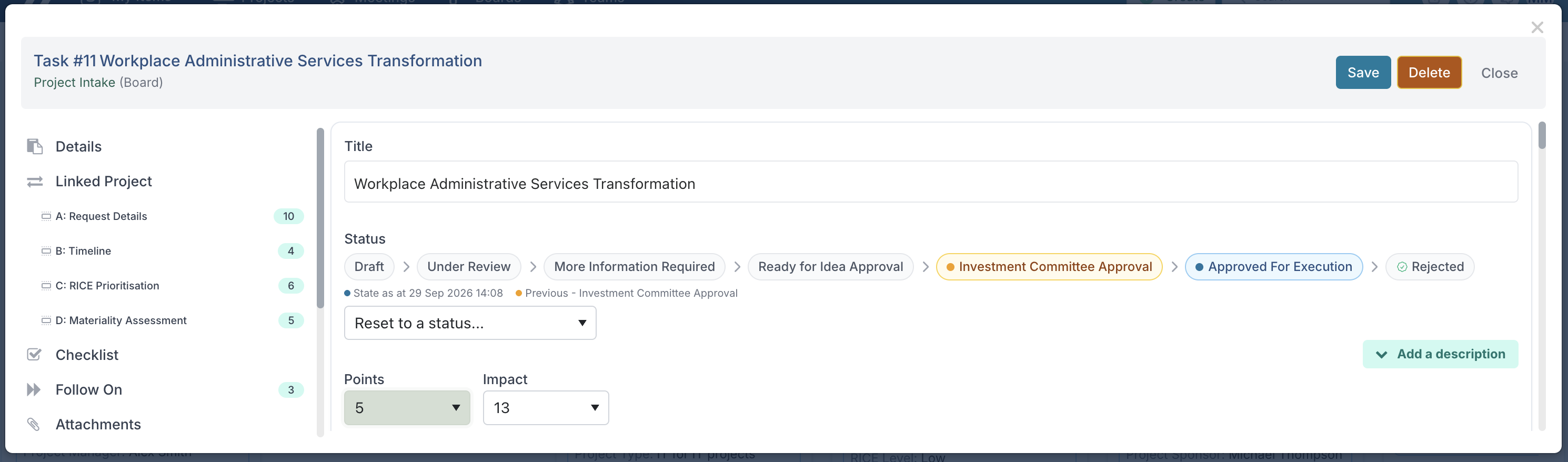

To reopen a card, use the Reset to a status dropdown. It lists the board's columns as they exist today.

Open cards, and closed cards on boards without the freeze setting, keep the ordinary clickable strip and never show the dropdown.

Archiving a card no longer loses its status

Archiving used to overwrite the card's status, so an unarchived card had lost its place in the workflow. Archiving is now a flag beside the status, and the card keeps the column it was in.

What you'll see

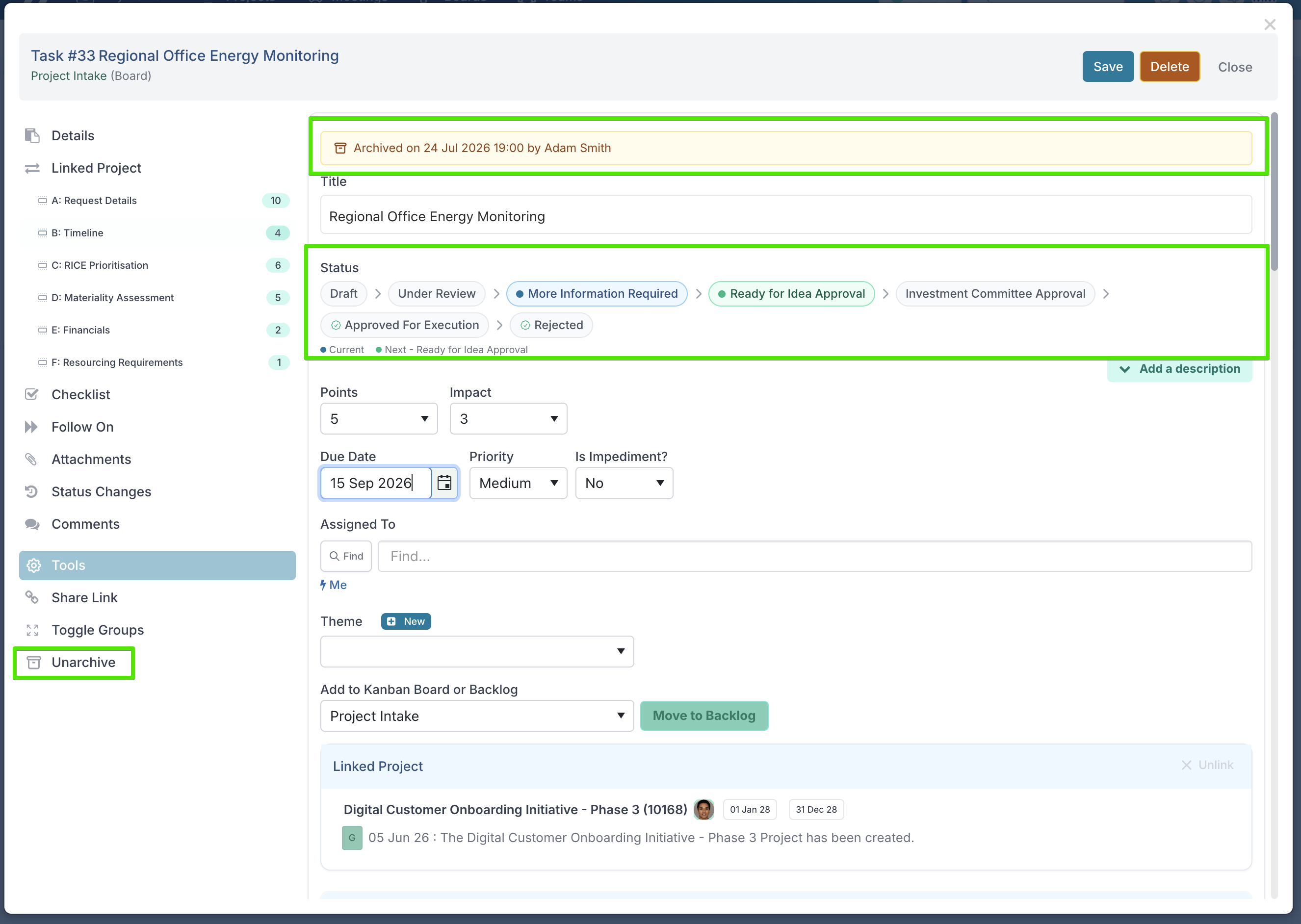

  • An archived card shows an amber bar above its title saying when it was archived — that bar, not the status strip, is what marks a card as archived. The status strip keeps showing the column the card was in when it was archived.

  • Archiving takes the card off every open board immediately, for all users.

How to archive and unarchive

As archiving is now handled separately from the card’s workflow status, Archived no longer appears as though it were another status in the process. The action is available from Tools in the card dialog, where it appears as Archive for active cards and Unarchive for archived cards.

When you archive a card, Fluid confirms the action before moving it off the board into Archive History. The card keeps its existing status, and required fields do not prevent it from being archived.

When you unarchive a card, it returns to the status it had when it was archived. You can also restore an archived card directly to a different status by selecting that status from the card’s status strip.

Decide per board whether card descriptions are optional, hidden or required

Different boards use card descriptions in different ways. A lightweight triage board may not need them at all, while a request or intake board may need every card to explain what is being requested. Board administrators can now control this using the new Card Description setting on the board's Settings tab.

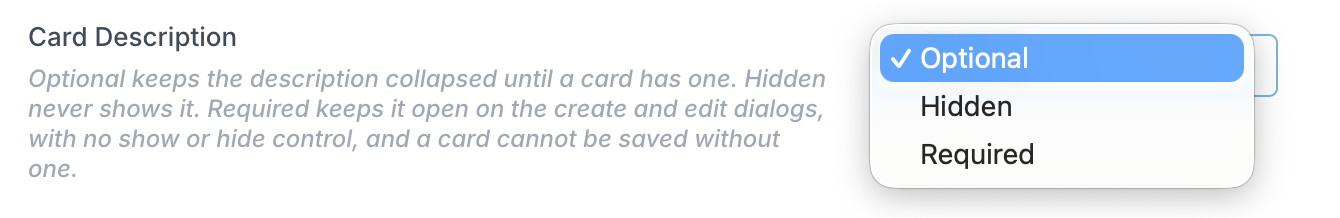

  • Optional: keeps the current behaviour. The description remains available behind Add a description, but is not required. This is the default, so existing boards are unchanged.

  • Hidden: removes the description from card create, edit, read-only and approval views. Existing description content is retained and becomes visible again if the setting is changed later.

  • Required: keeps the description field expanded in create and edit views and prevents a card from being created or saved without meaningful content. The same validation also applies to integrations and API calls.

For required descriptions, Fluid checks for actual content rather than just editor formatting. Blank paragraphs, line breaks or spaces do not count, while an embedded image does.

Project Pipeline

Editors and Viewers carry through to the project

People named in a pipeline card's Editors and Viewers fields are now added to the project the card creates or syncs to, with matching access: Editors can edit the project, Viewers can open it read-only.

How to set it up: on your pipeline board, give the card a person field (single or multi-person) for each role, named to match your configured Editors and Viewers labels. If your organisation uses the default labels, name the fields Editors and Viewers; if you've renamed the roles in Admin → Activity Setup → Project Community (say, to Project Editors and Project Observers), name the card fields Project Editors and Project Observers.

When the people are carried across:

  • Creating a project from a card — everyone in the card's Editors and Viewers fields is added to the new project's stakeholders, and the person who created the project is added as an Editor as usual.

  • Syncing a linked card — add people to the card's fields later, and they're added to the project when the card next moves into a sync column.

  • Refreshing a card from its project — using Refresh Project Metadata on a linked card fills the card's Editors and Viewers fields from the project's current stakeholders, so the card reflects who actually has access.

The card only ever adds people — it never removes them. Taking someone out of a card's Editors or Viewers field does not take away their access to the project. To revoke access, remove the person from the project's own stakeholders.

Schedules and Timesheets

Choose whether timesheets update schedule % complete

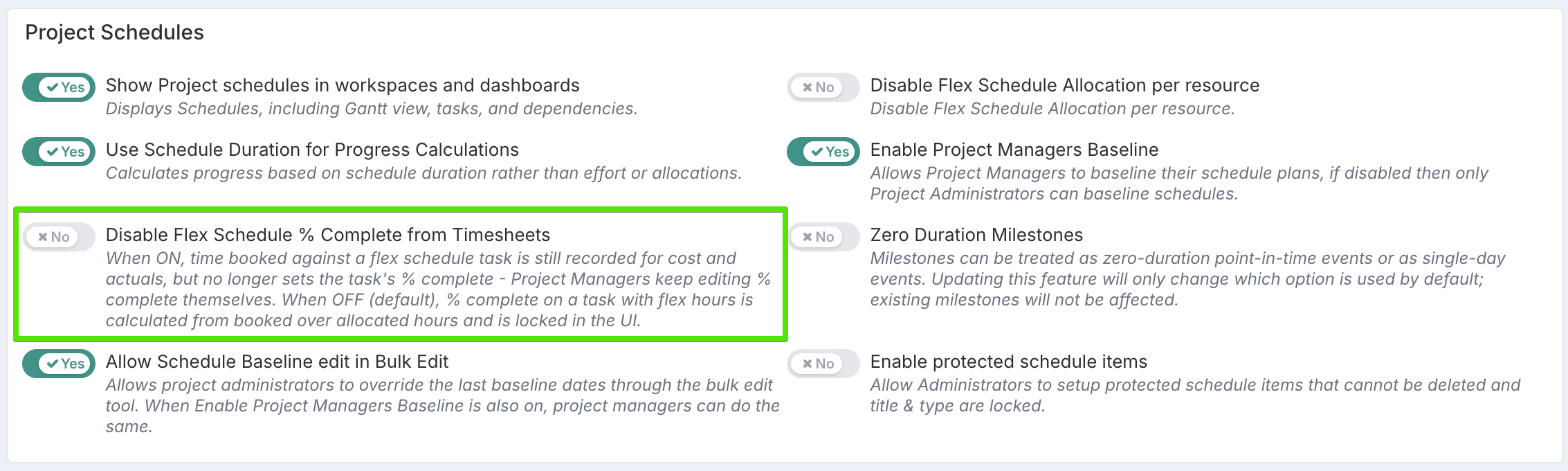

A new system setting, Disable Flex Schedule % Complete from Timesheets, under Setup Project Features → Project Schedules, lets organisations separate time booking from progress tracking on flex schedule tasks.

When the setting is off, the existing behaviour continues unchanged. When Flex Schedules and Timesheets are enabled, % Complete for tasks with flex hours is calculated from hours booked against hours allocated. Project managers cannot edit the value directly, and the task remains below 100% until it is marked complete.

When the setting is on, timesheet entries no longer update % Complete. People can continue booking time as normal, and those hours still contribute to cost, actuals and capitalisation. Progress is instead managed manually by the project manager, including for tasks that already have booked time.

This is particularly useful when introducing timesheets to projects already in progress, because existing PM-entered progress is preserved rather than being replaced by an hours-based calculation. It also supports organisations that use timesheets primarily to capture effort and cost rather than to measure delivery progress.

The setting applies across the whole instance and is off by default. If it is later turned off again, existing tasks are not recalculated immediately. Their hours-based % Complete is picked up the next time time is booked against the task or the task is saved. Summary tasks continue to roll up their children's progress, weighted by allocated hours, regardless of how each child's % Complete was set.

Other Enhancements & Fixes

  • Schedule tasks: Fixed copying/cloning schedule tasks occasionally giving an unrelated summary task the wrong end date.

  • Schedule Bulk Edit: uploading a schedule can no longer give a task a RAG that contradicts its progress, i.e. an unfinished task can't end up with a "Completed" RAG, and a started task can't keep "Not Started". Where the spreadsheet's RAG doesn't match the task's status, the task keeps its current RAG (or gets the default), and the upload report lists each correction.

  • Project % complete now matches the Gantt: the project-level completion percentage could show a slightly lower figure than the Gantt grid calculated for the same plan, because rounding was applied at every level of the task hierarchy instead of once at the end. Both now calculate identically.

  • Financials by Project: column headings, the Totals row and the Project column now stay visible while scrolling; a new Show Margin toggle in Filters & Options lets you hide the Margin column (remembered across sessions); and printing now includes the full grid.

  • Governance checks: the Impacts Recently Updated and Schedule Recently Updated assessment checks now pass when a project has no open impacts or no open schedule items — previously a project with nothing open was wrongly marked non-compliant for that check.

  • Catalog custom properties: clearing a catalog selection now stays cleared after saving. Previously the removed selection silently reappeared when the item was reopened. Removing one value from a multi-select catalog property is saved correctly too.

Was this article helpful?
